When Hurricane Helene surged across the Tennessee/North Carolina border in 2024, the Pigeon River swelled beyond historic levels and ripped a segment of Interstate 40 from its foundation. The river’s relentless force caused a phenomenon known as scouring washing away the roadbed and plunging the pavement into the water. Before the storm, the highway carried roughly 26,000 vehicles a day after the washout, it became a disconnected lifeline for the rural communities that rely on it.
Instead of simply replacing the lost pavement, state engineers launched an ambitious effort to build a structure that can endure a 500-year flood—the type of event that reshapes the landscape only once in many centuries. The plan, documented in a BuildWitt video series, combines massive concrete geometry with steel reinforcement to create a defensive envelope that deflects future floodwaters before they can erode the road again.
The damage caused by Hurricane Helene
Helene’s rains added more than 30 inches of water in a matter of hours, raising the Pigeon River to a level that exceeded any design forecast. The surge stripped away the soil supporting the highway, a process engineers describe as scouring and left a gaping hole where the road once lay. While two lanes remained temporarily open, traffic was forced onto a precarious soil-nail wall measuring about 290,000 square feet. This wall consists of massive steel rods driven into the hillside, keeping the earth under tension and preventing further collapse.
Engineering the flood-proof wall

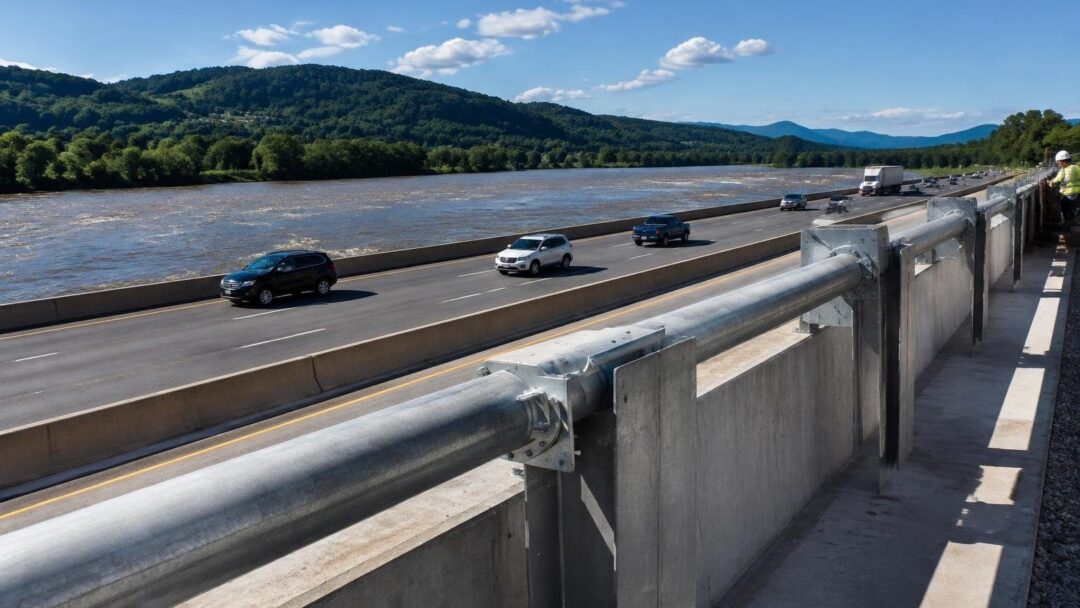

At the heart of the reconstruction is an 800,000-yard roller-compacted concrete (RCC) barrier. Unlike traditional concrete, RCC is laid down in thin layers by dump trucks, then compacted with rollers—hence the name. The wall tapers from a 30-foot base to a 10-foot top where it seamlessly integrates with the roadway surface, forming a stepped shield that redirects water away from the underlying foundation.
Roller-compacted concrete barrier
To create the RCC wall, more than a million yards of rock were required. Because the site sits deep inside a remote gorge, the North Carolina government authorized a temporary quarry and concrete-mixing plant on-site. Workers constructed a dedicated haul road along the riverbank, then spent a full year moving material, mixing, and placing the concrete. Nighttime pours became the norm during the summer months, as cooler air slows the setting process and yields a denser, more durable slab.
Interlocking pipe-pile system
Complementing the concrete shield is an interlocking pipe pile (IPP) network made of roughly 400,000 linear feet of 36-inch steel pipe driven deep into the riverbank. This steel skeleton acts as the first line of defense, absorbing the kinetic energy of floodwaters and preventing them from reaching the RCC barrier’s inner face. The combination of RCC and IPP creates a dual-layered fortress designed to survive floods classified as “once in 500 years.”
Logistics of a remote gorge project
Transporting the massive quantities of material to a site isolated by steep terrain proved as challenging as the engineering itself. With no existing quarries nearby, a temporary quarry was excavated just for this job, alongside a concrete-mixing facility and a temporary haul road that followed the river’s curve. Once the reconstruction is complete, all provisional infrastructure—including the quarry, mixing plant, and haul road—will be dismantled and the land restored.
The construction timeline extends over a full year, a stark contrast to the days of destruction wrought by the hurricane. Yet the extended effort aims to secure a transportation corridor that will serve generations, ensuring that a single storm cannot sever the link between Tennessee and North Carolina again.
